Project: Nguyen Tat Thanh Road Section from Cam Ranh Airport to Long Ho Bridge

PROJECT OVERVIEW
-

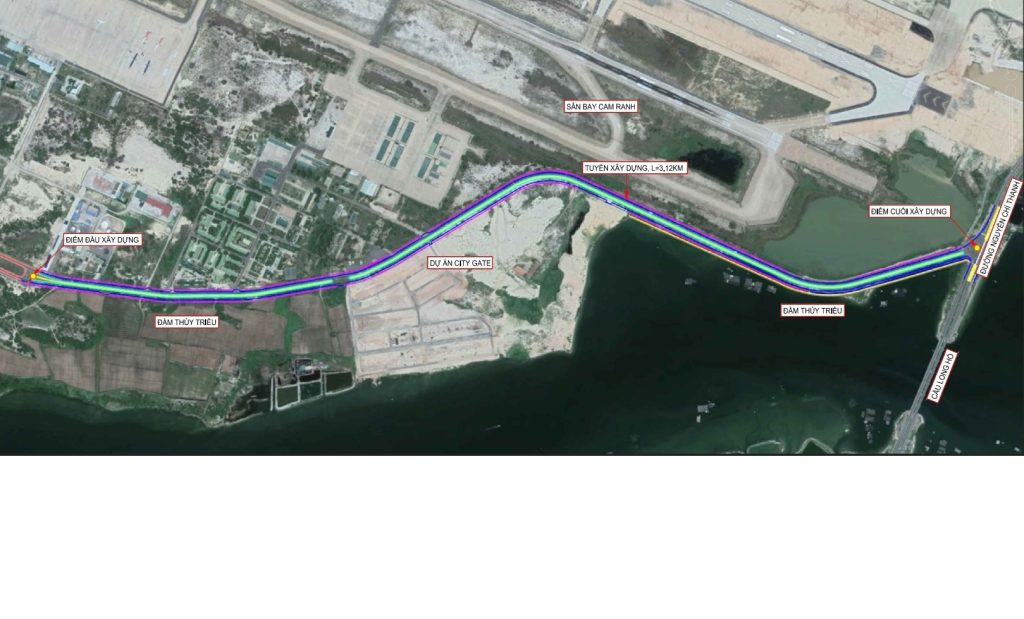

Location: Cam Nghia Ward, Cam Ranh City, Khanh Hoa Province
-
Project/Work Type and Class: Transportation Infrastructure Works
-
Supervision Contract Value: VND 1,053,918,000
-
Project Owner/Investor: Khanh Hoa Province Transportation Works Construction Investment Project Management Unit
-
Contract No.: 06/2024/HĐTV-NTThanh
DETAILED PROJECT INFORMATION
-
Goals and benefits
-
Highlights
-

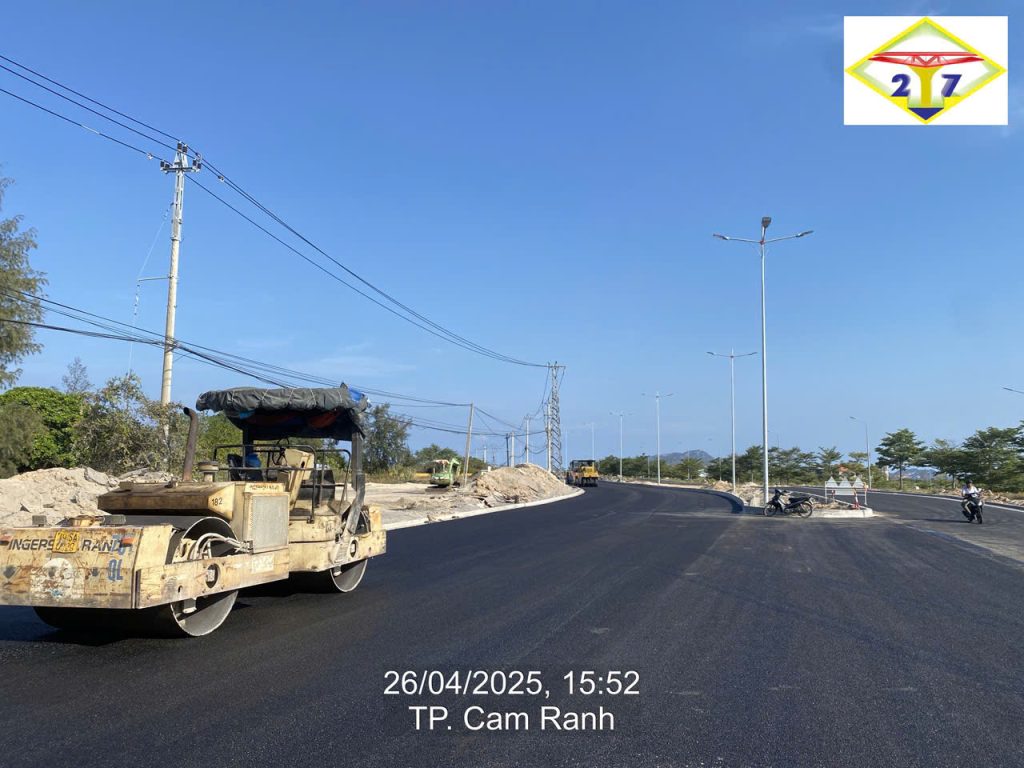

Progress & Results
-
Participating experts
-
Supervision Period
Main Task: Supervision of Civil Works and Installation for Package No. 05 of the project.

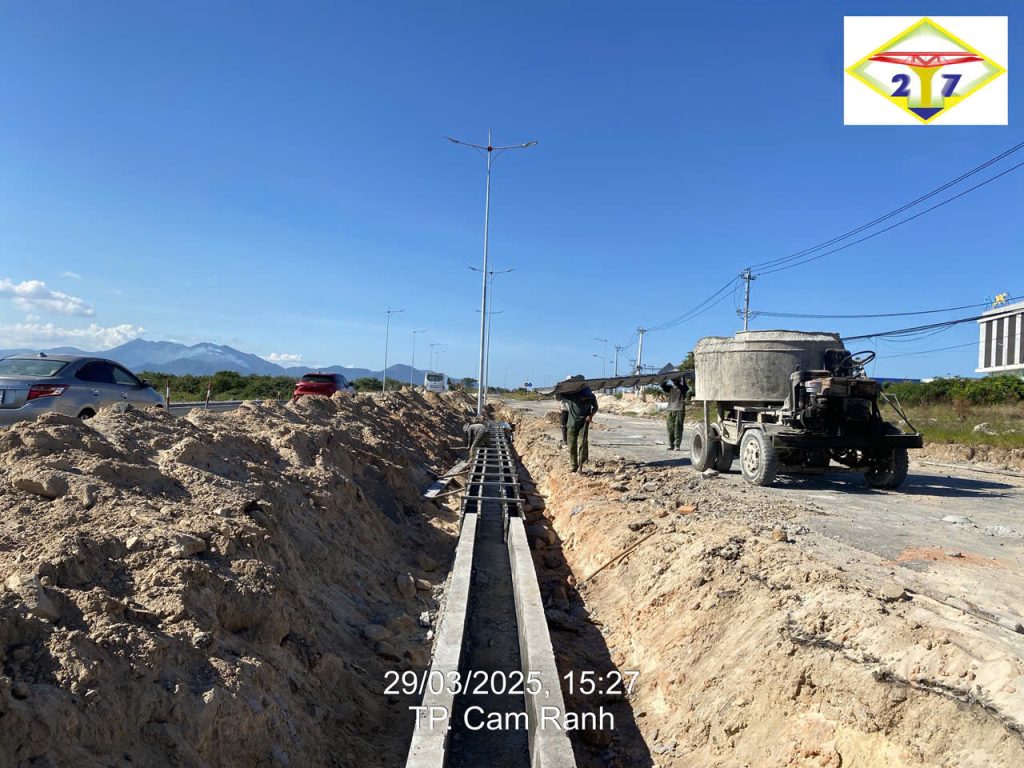

Scope of Supervision: Supervision of quality, quantity, progress/schedule, traffic safety, occupational safety, and environmental protection during the construction process.
Supervision Scope Allocation:
Viet Long Technology Development Co., Ltd.: Supervision of Lighting and Power Supply System Items (power lines and substations/transformer stations).

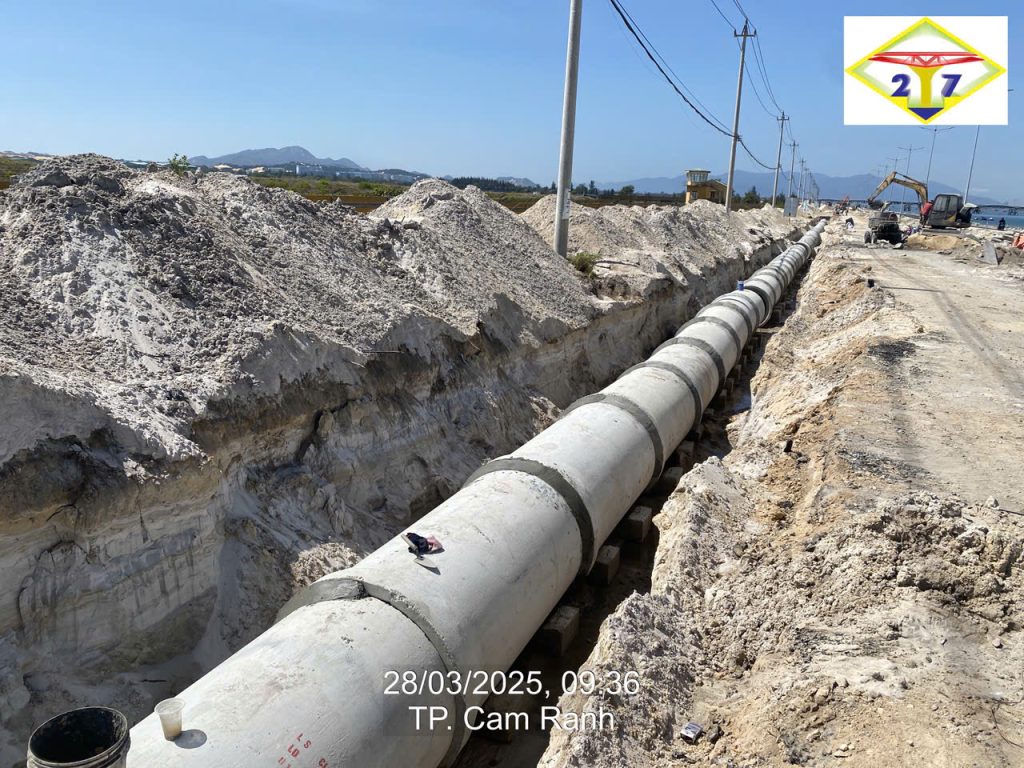

T27 Consulting Joint Stock Company (JSC): Supervision of Transportation Works Item (roadbed and pavement, longitudinal drainage, slope stabilization, traffic safety, storm drainage, utility trenches/duct banks, and cross culverts).

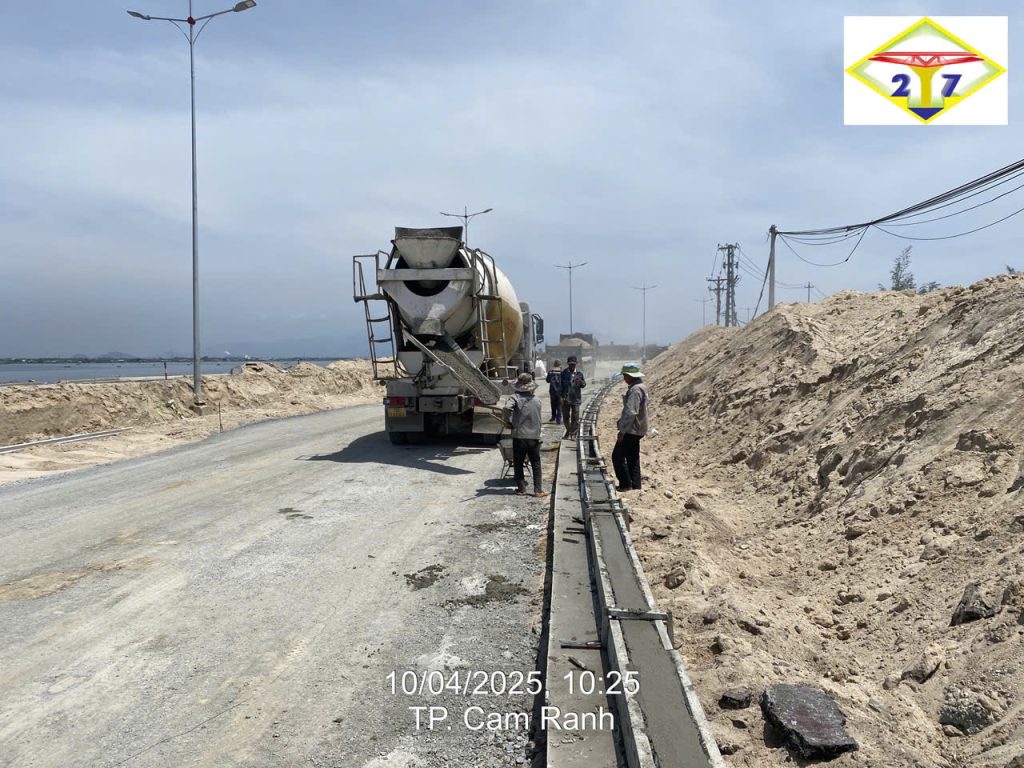

Quality Management: Strict control over materials, components, and equipment installed in the works; organizing comparison testing and quality inspection when necessary.
Project Warranty Period:
- 18 months for civil works items.
- 24 months for transformer equipment.
- 60 months for lighting fixture equipment.
Safety & Environment: Immediately suspend construction if the contractor violates occupational safety, traffic safety, or fire and explosion prevention regulations.
Total Implementation Period: 150 days and according to the construction period of the Work Package. Specific Timeline:
-
Commencement Date: October 05, 2024.
-
Estimated Completion Date: March 04, 2025. Detailed Schedule: Starts from the effective date of the Construction Contract (Package No. 04) until the works are accepted and put into operation/use.
Mobilization Mechanism: The Contractor shall deploy a sufficient number of personnel as proposed in the accepted Electronic Bidding Documents (E-HSDT).
Requirements: Personnel must possess appropriate professional practice certificates and expertise/qualifications. The Contractor must ensure supervisory personnel are stationed permanently and continuously at the construction site/site of work.
Total Implementation Period: 150 days and according to the construction period of the Work Package
